July is the beginning of the fiscal year and data is still being collected so the representative graphs will look incomplete and can cause confusion. As a result, in the month of July, the graphs are not shown for the current fiscal year.

Power System Reliability Program

The Power System Reliability Program provides a blueprint for ensuring continued reliable energy service for future generations of Los Angeles residents. LADWP implemented the Power System Reliability Program through a two-pronged approach—rebuilding infrastructure and proactive maintenance—and will invest more than $1 billion in the program over the next 5 to 15 years. The program is funded through a power reliability surcharge.

The goals of the program include:

  • Reducing Temporary Circuits
  • Replacing Distribution Transformers, Poles, Underground Cables, and Substructures
  • Reducing Frequency and Duration of System Interruptions
The table and graphs below detail the progress of the Power System Reliability Program.

Power System Reliability Program (PSRP) Activity Update as of July 03, 2022

Key Performance Indicators Units 21-22 Final Current Count FY 22-23 June 30, 2023 22-23 Target
System Average Interruption Frequency Index (SAIFI) Outages / year 0.81 - 0.78
System Average Interruption Duration Index (SAIDI) Minutes out / year 122.37 - 95.00

Priority A Circuits carrying extra load due to failed components Circuits 34 34 -
Priority B Circuits that have failed components   77 78 -
Priority C Circuits carrying extra load due to field work   89 91 -
Not yet prioritized   4 2 -

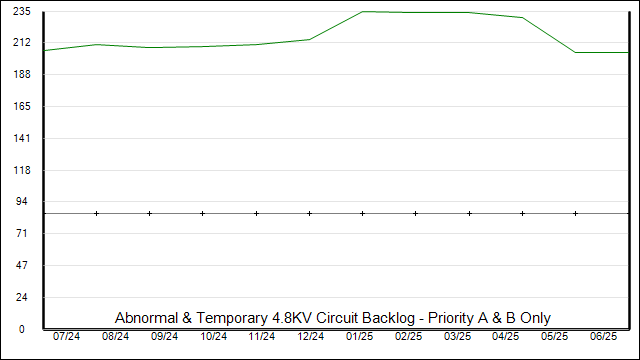

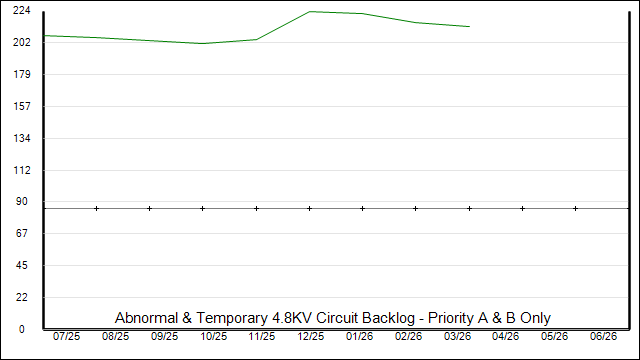

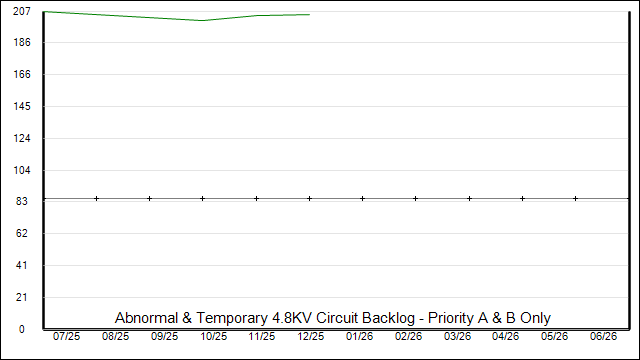

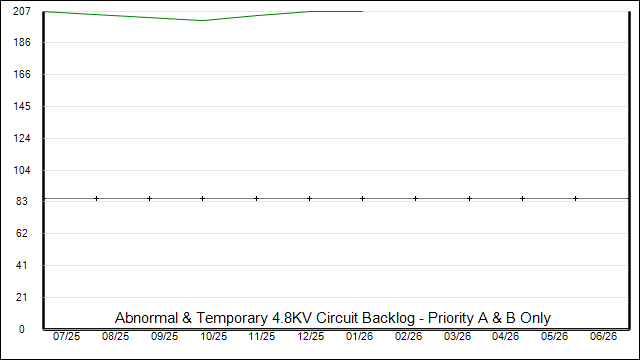

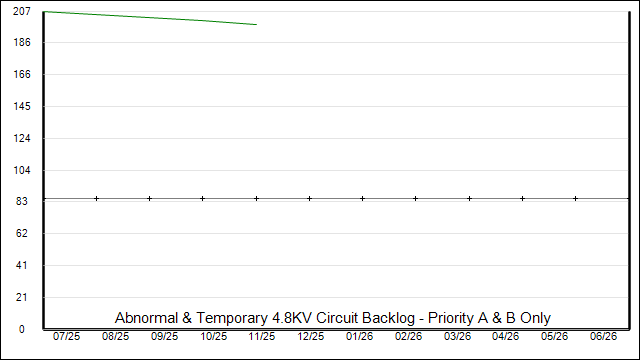

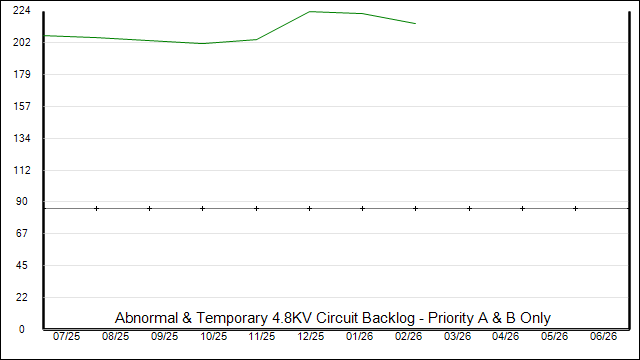

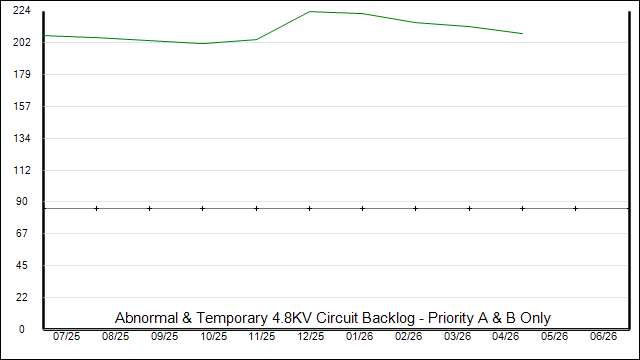

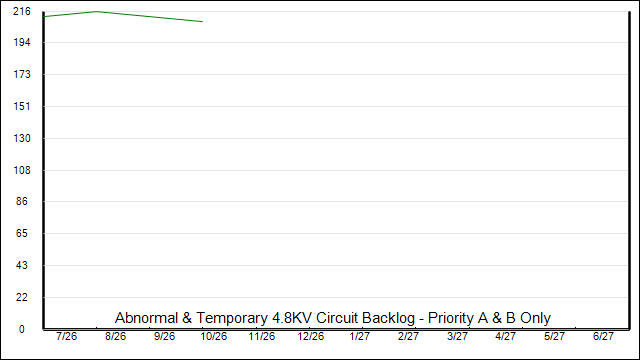

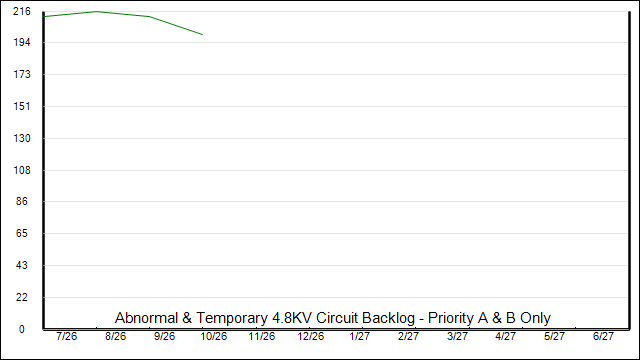

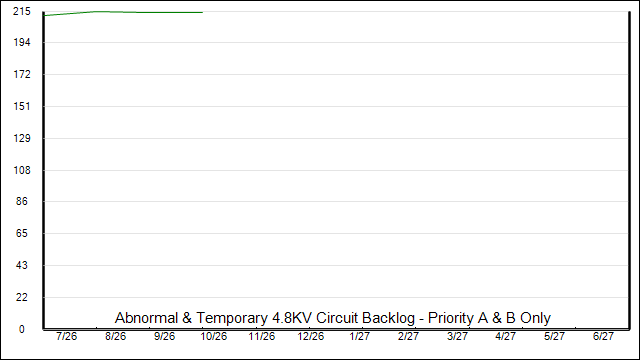

Abnormal & Temporary 4.8KV Circuit Backlog - Total of Priority A & B Only   112 112 85

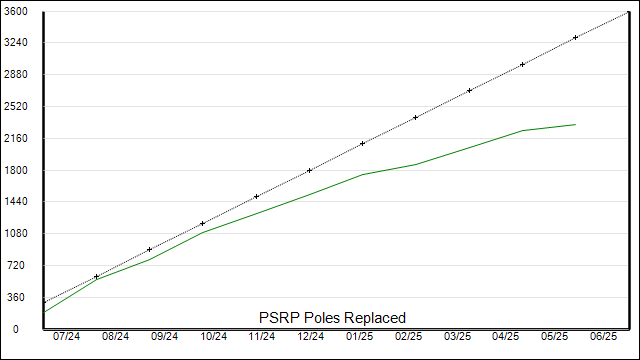

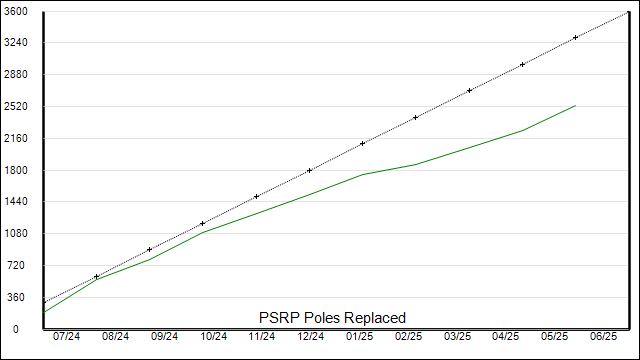

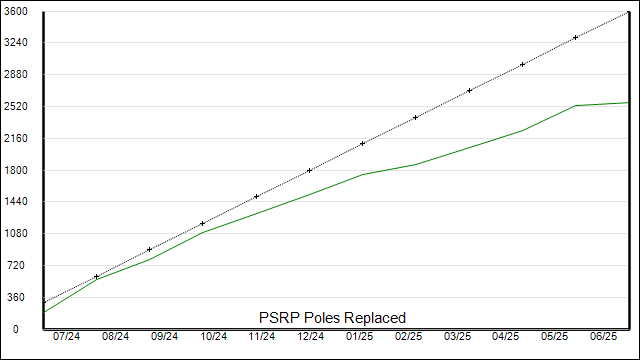

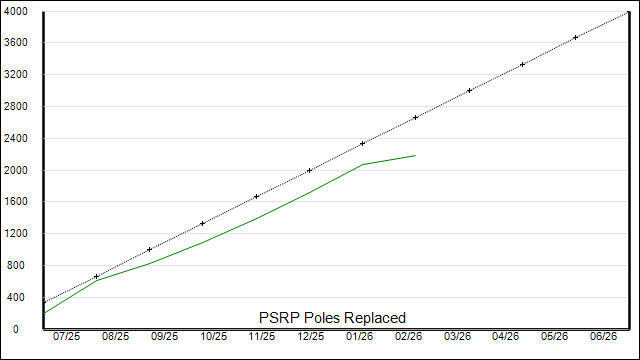

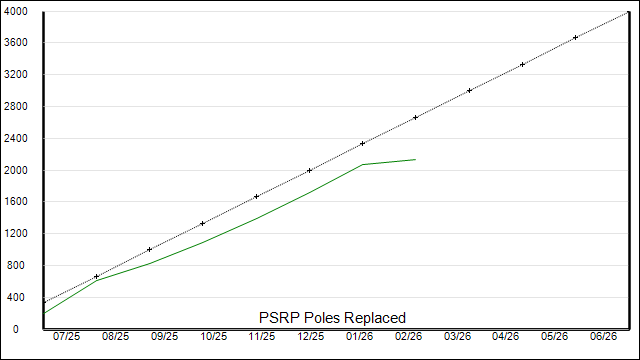

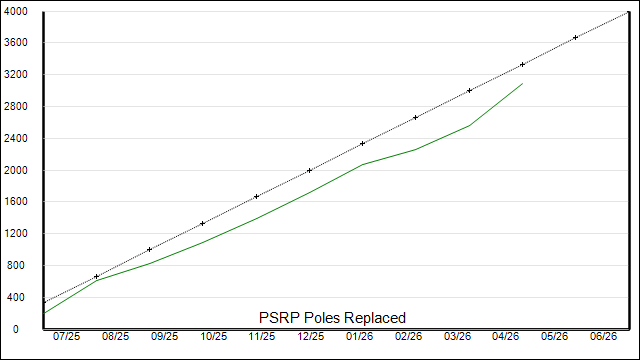

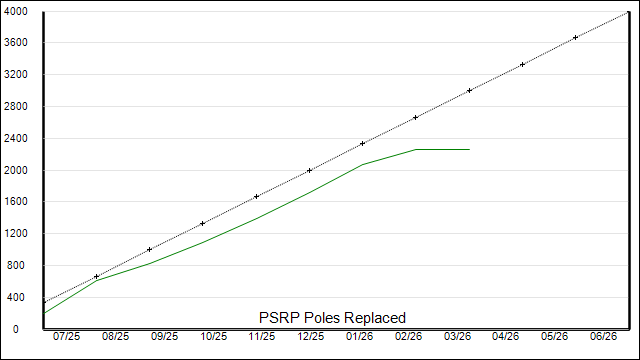

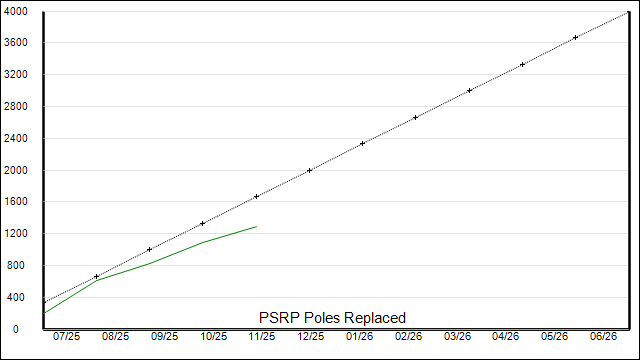

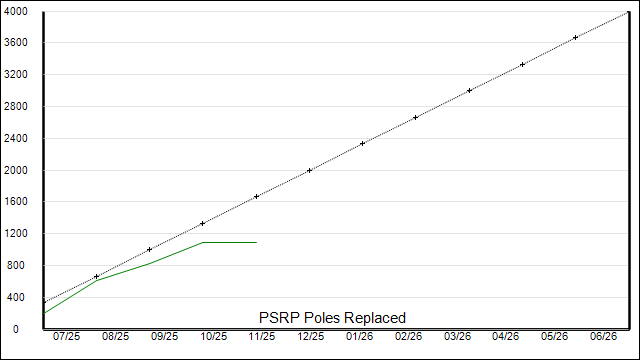

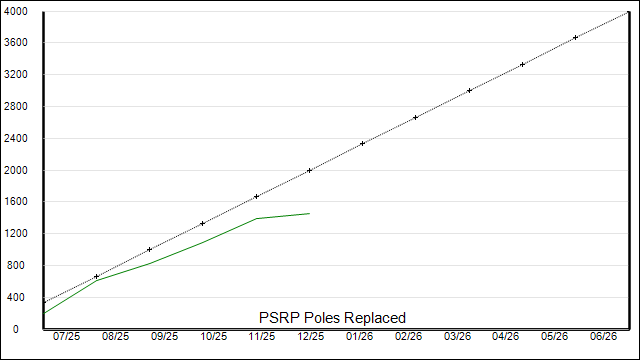

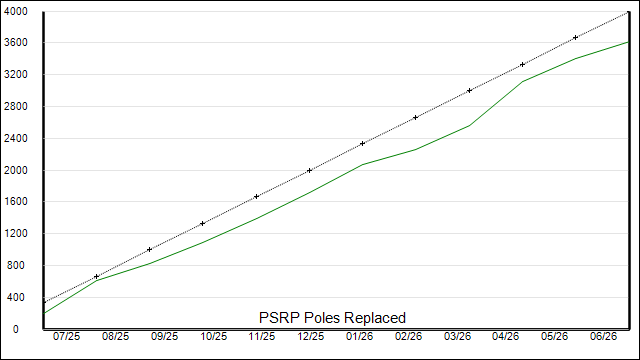

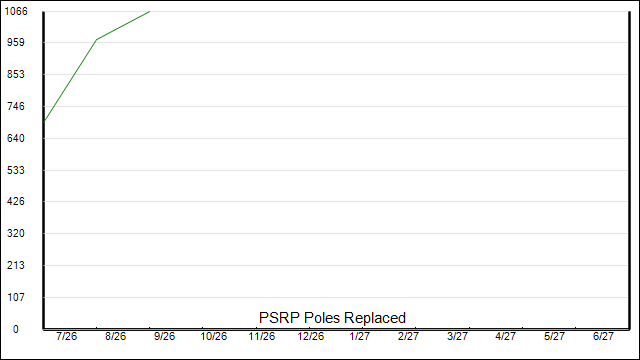

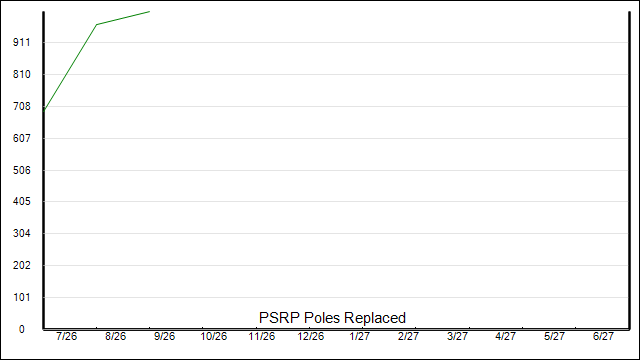

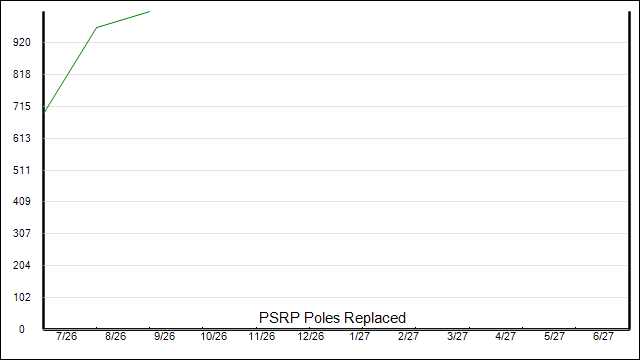

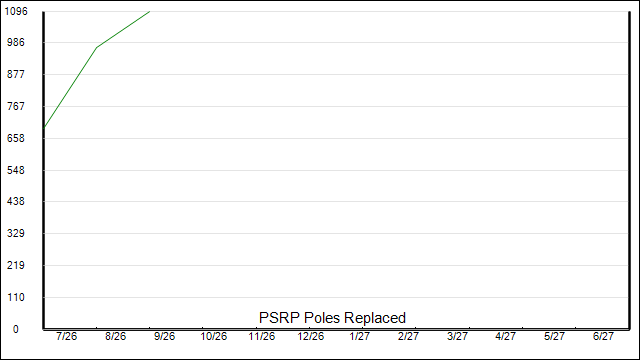

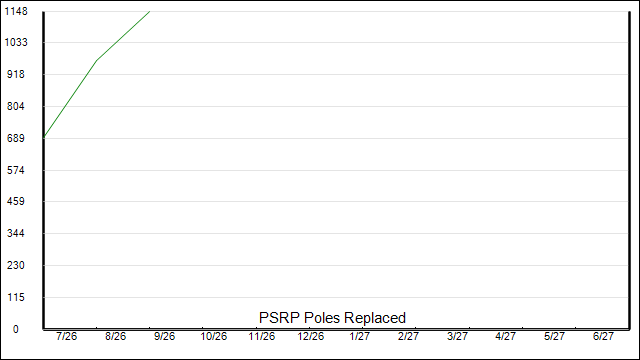

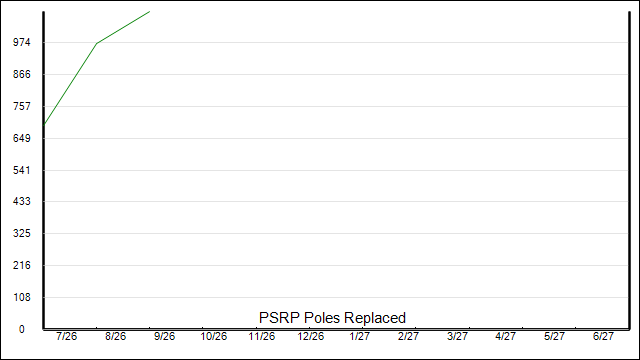

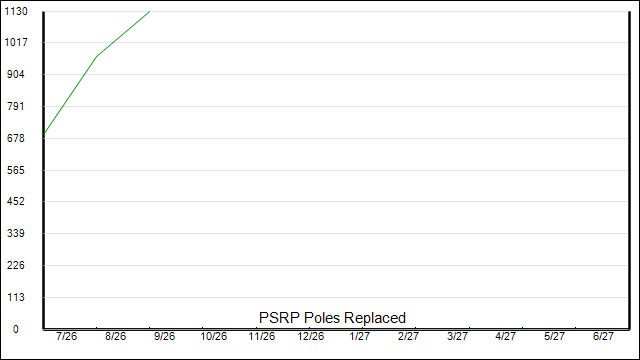

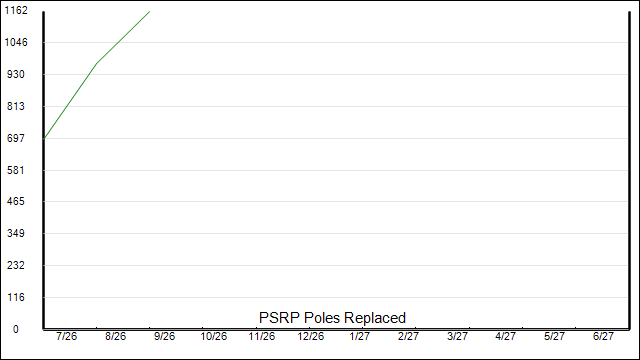

PSRP Poles Replaced Poles 3799 - 3500

PSRP Substructures Replaced and Repaired Vaults 21 - 22

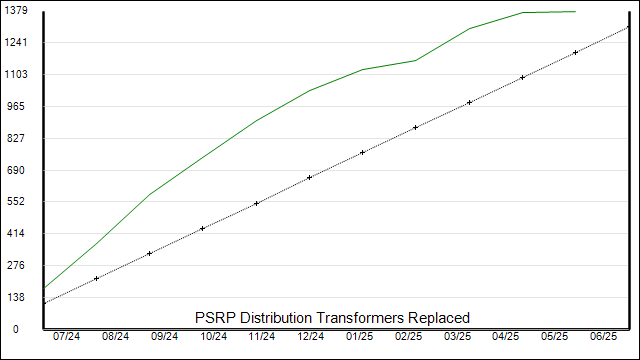

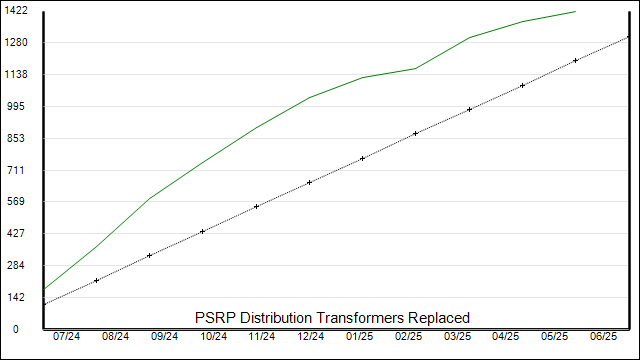

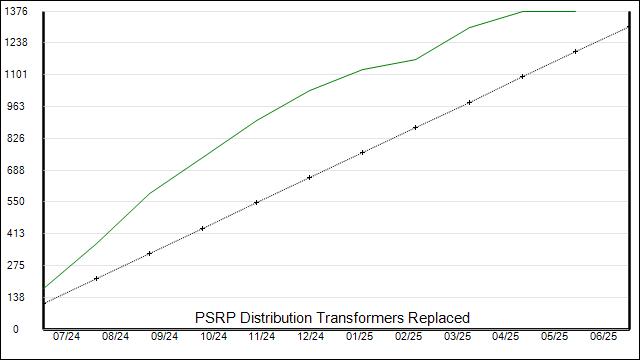

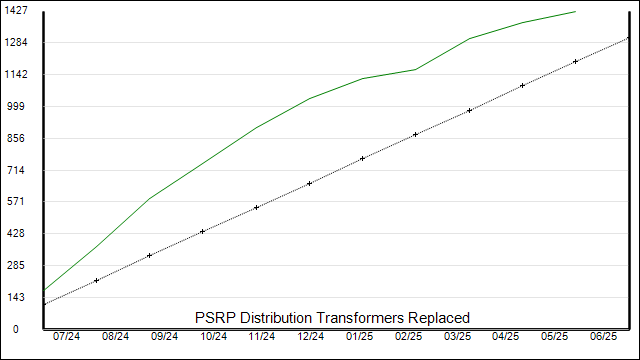

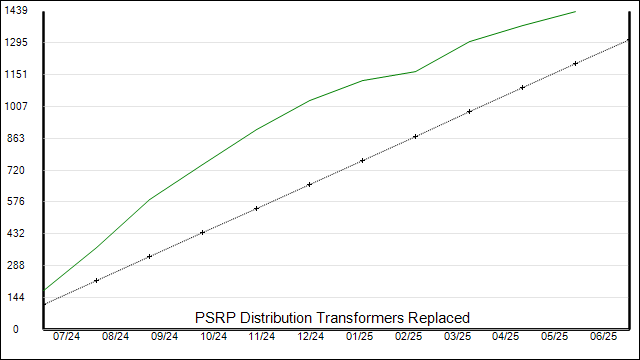

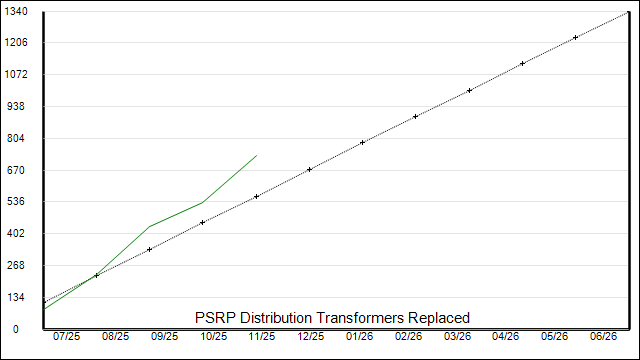

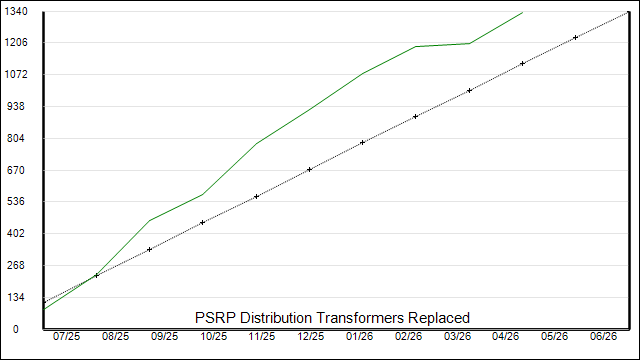

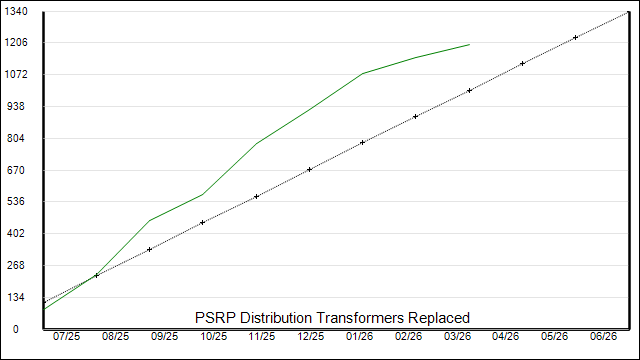

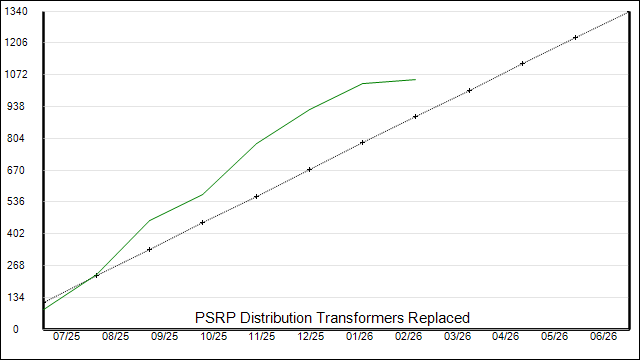

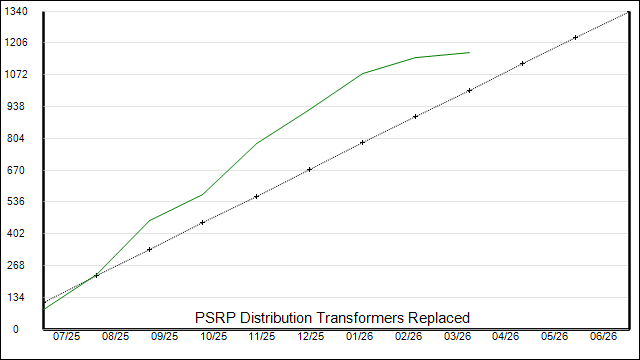

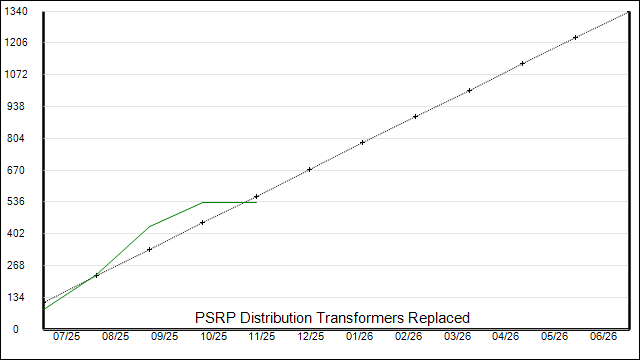

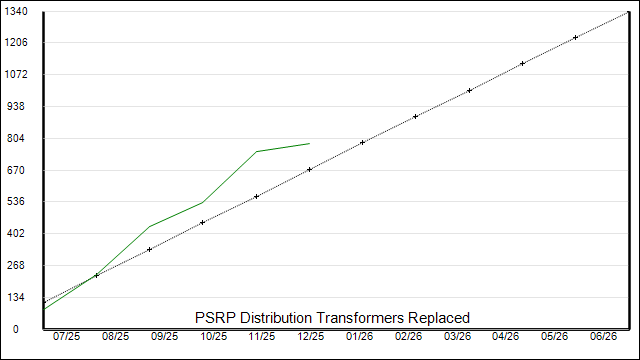

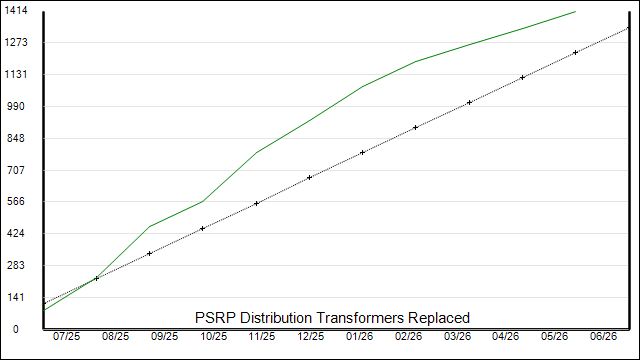

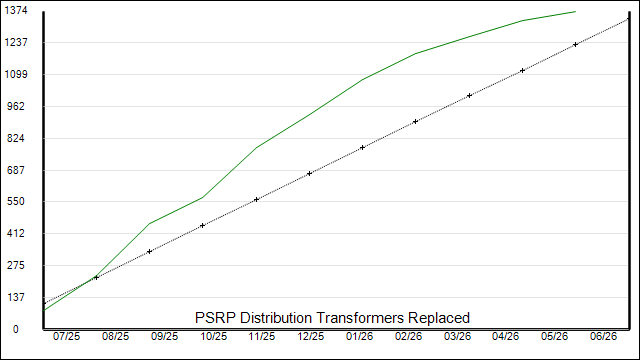

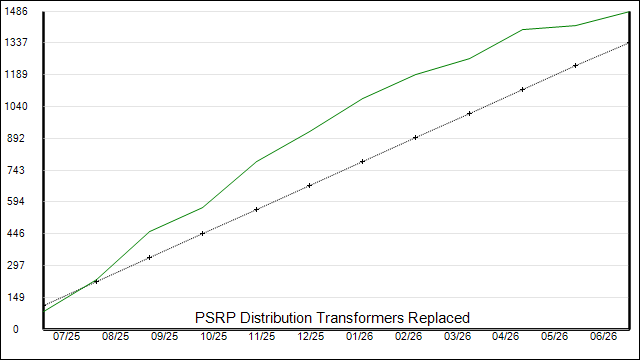

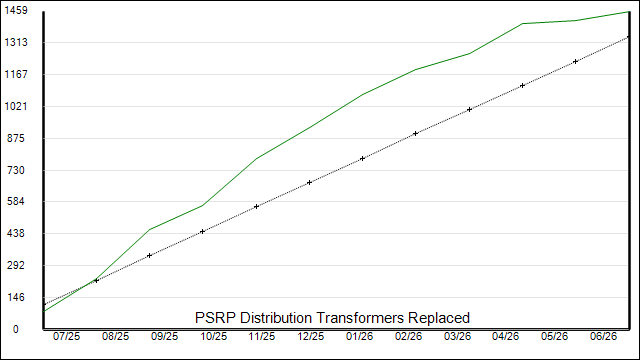

PSRP Distribution Transformers Replaced Transformers 1183 17 1150

Underground Transmission Cables replaced Cables 1 In Design 1 Cable

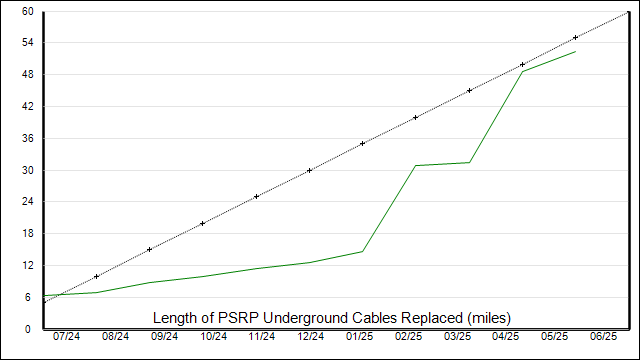

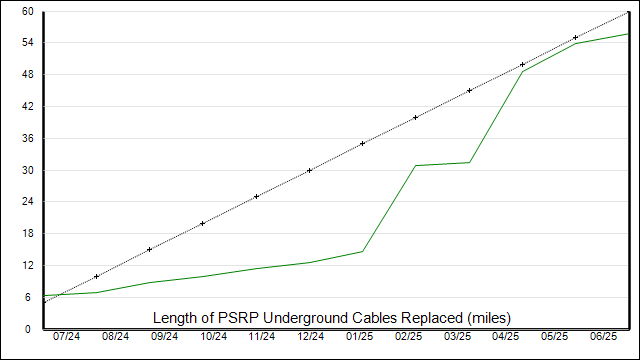

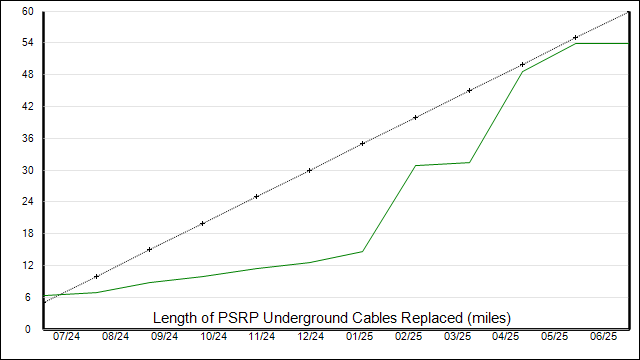

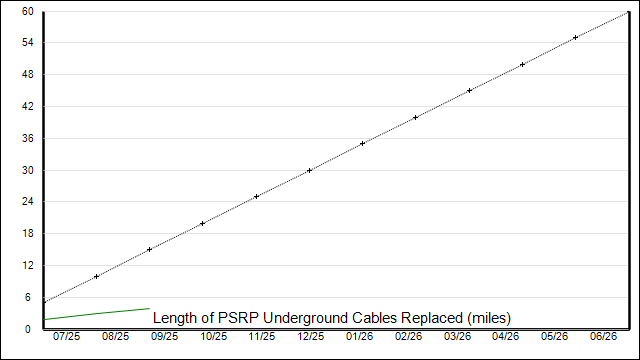

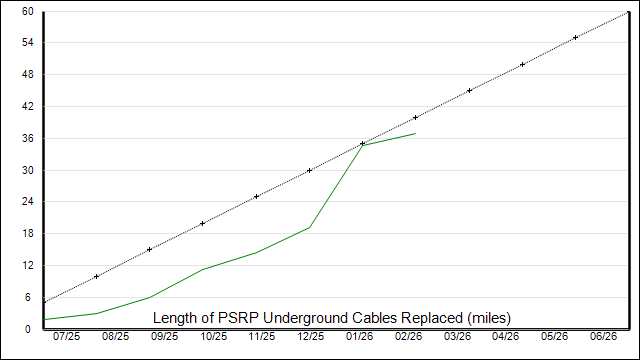

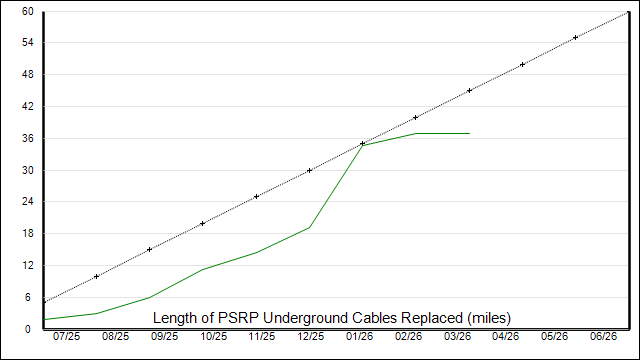

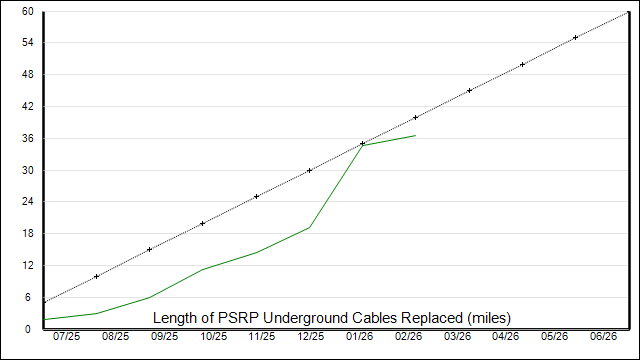

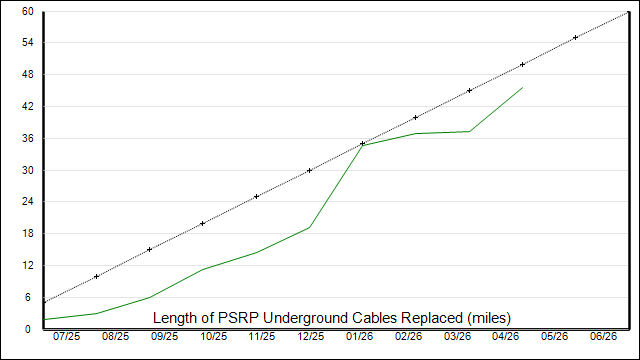

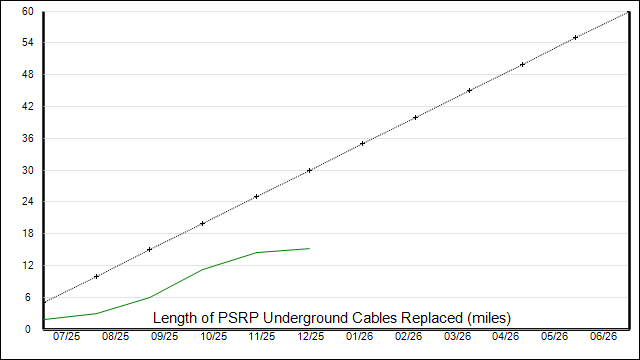

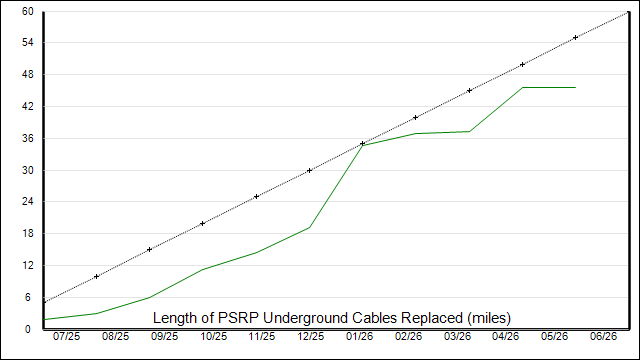

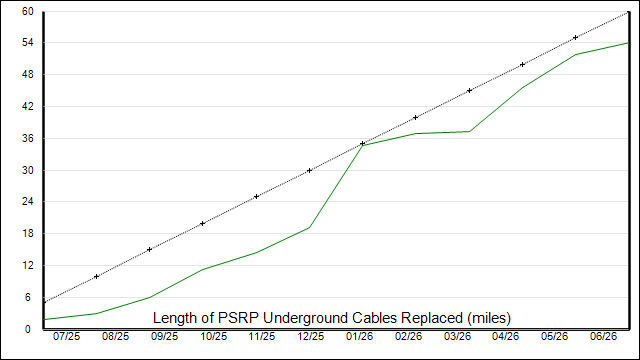

Length of PSRP underground cables Replaced Miles 51.9 - 60.0

NOTE: Starting with FY 13-14 the page has been redesigned to provide more clarity of the PSRP items being completed.
